双台阶水平井分层注水管柱设计及优化
张立义, 黄新业, 王金龙, 田志宏, 郭长永, 焦吾达
新疆油田公司工程技术研究院
摘要: 塔里木油田双台阶水平井的分注工艺无法满足分层注水要求,区块欠注问题严重。为此,设计了双台阶水平井分层注水管柱及其配套工具,并采用Wellcat软件模拟计算出单独注停上层、注停下层时上、下封隔器的受力情况,对伸缩管长度和封隔器剪钉进行配比优化,即上伸缩管控制伸缩距3 m,下伸缩管控制伸缩距1 m,上封隔器解封力108 kN,下封隔器解封力81 kN,满足该区块双台阶水平井200 m3/d、25 MPa条件下的分层注水。实际应用结果表明,注水管柱及配套工具设计合理,配合钢丝投捞并更换水嘴即可满足双台阶水平井分层注水。
关键词: 双台阶水平井    分层注水    注水管柱    集成式同心配水器    Wellcat    优化设计
Optimization of Multilayer Water Injection String for Two-step Horizontal Well
Zhang Liyi, Huang Xinye, Wang Jinlong, Tian Zhihong, Guo Changyong, Jiao Wuda
Engineering Technology Research Institute, PetroChina Xinjiang Oilfield Company
Abstract: Several two-step horizontal water injection wells have been drilled to waterflood thin sand reservoirs in Tarim Oilfield,and all were operated with general water injection,which could not meet the requirements of multilayer water injection,resulting in serious water injection regulation problem.To address the issue,taking multilayer water injection in the Well ××1 in Tarim Oilfield as objective,a multilayer water injection string and supporting tools for two-step horizontal well has been designed.The forces on the upper and lower packer under water injection in upper or lower layer have been calculated by using Wellcat.The telescoping tube length and packer shear pin have been optimized.The upper and lower telescopic tube should has telescopic length of 3 m and 1 m respectively.The upper and lower packer should have releasing force of 108 kN and 81 kN respectively.The developed string could meet the multilayer water injection in the two-step horizontal wells under the injection rate of 200 m3/d and pressure of 25 MPa.The application results showed that the designed multilayer water injection string for two-step horizontal well is rational and could meet the requirements for multilayer water injection in two-step horizontal well with slickline operation for replacing nozzle.
Key words: two-step horizontal well    multilayer water injection    injection string    integrated concentric water regulator    Wellcat    design optimization

0 引言

传统的分层注水工艺只适用于直井[1]。目前,由于分注工艺限制,国内水平井基本采用笼统注水[2]。欧美一些大型的石油公司有自己成熟的智能完井技术[3],该技术可用于水平井分注,但是费用高昂,无法推广。水平井分层注水一直是国内外注水界难题。

塔里木油田薄砂层油藏,油层薄、分布稳定,平均井深5 500 m,地层温度150 ℃、上层与下层物性差异较大,整体采用大井距的双台阶水平井注采井网开发。现有双台阶水平注水井多口,受技术条件限制,全部采用笼统注水,由于2层物性差异较大,注入水全部进入物性较好层,区块欠注问题严重。笔者旨在设计多种工具及管柱结构,同时采用Wellcat软件模拟,优化各工具及管柱结构,以满足双台阶水平井分层注水要求。

1 配套工具设计

为满足水平井分层注水要求,设计了集成式同心配水器工作筒、注水芯子、坐封芯子、芯子打捞器和芯子脱开器。为了完成封隔器验封及吸水指示曲线测量,设计了注水芯子与双探头压力计、上下集流式流量计配合结构。配水器的主要功能是将油管中的水分成2路,一路由注水芯子滤孔,经过第1级水嘴后进入上层,第2路经芯子与工作筒的环形空间后,绕过上层出水桥,由芯子下部进水孔进入注水芯子,经下层水嘴进入油管,注入下层,具体结构如图1所示。

图 1 集成式同心配水器 Fig.1 The integrated concentric water regulator 1-上层水嘴;2-下层水嘴。

为实现下封隔器验封,设计双探头压力计与注水芯子配合结构,如图2所示。验封过程采用油管正加压方式,压力计传感器在上层压力传感孔位置测得压力为两封隔器间压力,油管注入液体沿工作筒环形空间绕过上层桥式通道,全部注入下层,即压力计传感器在下层压力传感孔位置测得油管压力。若下封隔器密封不严,则2只压力计测得的压力曲线形态相同或相近,若2只压力计测得的曲线有明显台阶,则说明下封隔器密封良好。

图 2 集成式同心配水器验封结构 Fig.2 Seal test mechanism for the integrated concentric water regulator 1-双探头压力计;2-注水芯子。
2 管柱结构设计

由于该井较深,采用2只具有锚定功能的Y441封隔器,其中上层Y441封隔器作为套管保护封隔器。全井计划采用钢丝投捞水嘴,配水器必须位于直井段,为减小两封隔器间跨距,上层Y441封隔器位于配水器以上,尽量靠近配水器,下层封隔器下至2水平段之间稳斜段(B、C段)将2水平段封隔。由于注水过程中管柱要收缩,停注时管柱要相对伸长且上层封隔器与井口之间、2封隔器之间跨距较大,则上、下封隔器需具有上、下锚定功能,必须配备合理伸缩管,对油管伸长缩短加以补偿,避免封隔器受油管上拉力而非正常解封,导致分注失败。

××1井A点垂深5 000 m,斜深5 200 m,B点垂深 5 002 m,斜深5 300 m,C点垂深5 020 m,斜深 5 400 m,D点垂深5 022 m,斜深5 550 m。套管结构如表1所示。

表 1 ××1井套管结构 Table 1 Casing program of Well ××1
套管外径/mm 下入井段/m 钢级 壁厚/mm 水泥返高/m
244.5 0~900 TP110 11.99
177.8 0~3 300 TP110 10.36 1 950
139.7 3 300~5 600 TP110 9.17 3 500

该井分层注水管柱结构见图3。油管采用复合结构,88.9 mm(3 1/2 in)UP TBG油管下至1 200 m,73.0 mm(2 7/8 in)UP TBG油管下至5 425 m。

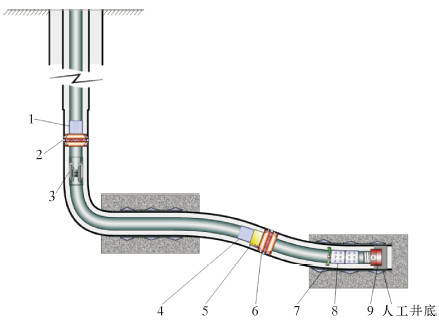

图 3 全井管柱结构 Fig.3 The whole string structure 1、4-伸缩管;2、6-Y441封隔器;3-集成式同心配水器;5-安全接头;7-球座;8-打孔短节;9-底丝堵。
3 管柱受力分析及优化

伸缩管分为定压开启式与拉力开启式2种,其中定压开启式是指管柱坐封过程中,将伸缩管打开,注水及停注过程伸缩管可自由伸缩。拉力开启式是指注水过程中,通过管柱收缩产生的拉力将伸缩管剪钉接断,达到开启伸缩管目的。本管柱工艺采用定压开启式伸缩管。伸缩管剪钉设计原则时,首先要保证伸缩距满足管柱缩短要求,其次剪切力大于伸缩管以下管柱重力10~20 kN入井过程中避免剪钉拉断。本管柱工艺中上伸缩管以下油管自重58 kN,下伸缩管以下油管自重9 kN。

整体注水管柱为2层分注,最为严酷条件为一层吸水、另一层不吸水,即全井水量全部注入上层或下层,若此时管柱设计满足工况,则2层同注时注水管柱同样安全有效。软件计算中考虑膨胀、螺旋弯曲、温度、活塞及井斜影响[4, 5]

3.1 单独注、停下层时管柱受力分析及优化

伸缩管选择定压开启式,封隔器启动压力为6 MPa、完全坐封压力20 MPa,伸缩管开启压力25 MPa,球座击落压力30 MPa,即坐封过程中,伸缩管已开启,保证注水过程中,伸缩管可自由伸缩。该区块设计最大注入量200 m3/d,井口注水压力25 MPa,将该井深、井斜和方位角导入Wellcat,井口流体注入温度30 ℃,井底温度150 ℃,封隔器耐压差50 MPa。

软件模拟结果如表2所示。由表可知,当所有水全部注入下层时,井口到第1个封隔器(即0~4 800 m)管柱收缩2.883 m,停注时收缩0.435 m,即管柱由注水时收缩2.883 m,停注后管柱重新伸长2.448 m。Y441(上)至Y441(下)段管柱,注水时管柱收缩0.863 m,停注时管柱收缩0.144 m,即由注水转停注后管柱伸长0.791 m。

表 2 单独注、停下层时全井管柱长度变化 Table 2 The length changes of the whole string under water injection only in the upper layer
m
加载状态 顶部深度 底部深度 虎克 屈曲 鼓胀 热效应 整体长度变化 屈曲长度
注水 0.00 4 800.00 0.056 -0.029 -0.739 -2.172 -2.883** 755.91
注水 4 800.00 5 330.00 0.032 -0.002 -0.072 -0.392 -0.435** 182.68
停注 0.00 4 800.00 0.013 0.000 -0.003 -0.873 -0.863** 0.00
停注 4 800.00 5 330.00 0.002 0.000 -0.001 -0.145 -0.144** 0.00

单独注、停下层时上、下层封隔器受力如表3表4所示。表中FF分别表示油管对上、下封隔器的下压力,pp分别表示上、下封隔器的环空压力,t表示温度。由表3表4可知,当伸缩管打开,注水时油管对上封隔器下压力64.262 kN,停注时油管对上封隔器下压力55.415 kN,注水时油管对下封隔器下压力40.104 kN,停注时油管对下封隔器下压力57.722 kN,既注水、停注过程,全井封隔器受到下压力,整体管柱设计满足要求。

表 3 单独注、停下层时上层封隔器受力 Table 3 The forces on the upper packer under water injection only in the upper layer
状态 F /kN F /kN p /MPa p /MPa t/℃
注水 -64.262 -18.688 46.878 46.879 84.156
停注 -55.415 -36.306 46.342 46.343 122.208
表 4 单独注、停下层时下层封隔受力 Table 4 The forces on the lower packer under water injection only in the upper layer
状态 F /kN F /kN p /MPa p /MPa t/℃
注水 -40.104 -82.336 49.016 69.076 93.353
停注 -57.722 -57.722 48.425 48.427 129.096
3.2 单独注、停上层时管柱受力分析及优化

单独注上层时,则全井管柱需等价于2口井来分析。井口至上封隔器等价于单井加1只Y441(上)单独分析,而Y441(上)至Y441(下)部分等价于第1只Y441为井口,全井接1只Y441(下)且只加套压不加油压情况。

3.2.1 井口至上封Y441段

单独注、停上层时井口至Y441(上)段管柱长度变化如表5所示,Y441(上)受力如表6所示。由表5可知,井口到上层Y441封隔器(即0~4 800 m)管柱收缩2.885 m,停注时收缩0.864 m,即由注水转停注后管柱又伸长2.021 m。由表6可知,当伸缩管拉开,注水时油管对上封隔器下压力64.263 kN,停注时油管对上封隔器下压力55.416 kN,即明显看出在注水、停注中,井口至Y441(上)段管柱变化量(收缩、伸长量)基本相同,油管对Y441(上)封隔器施加力基本相同。

表 5 单独注、停上层时井口至Y441 (上)段管柱长度变化 Table 5 The length changes of the string between the wellhead and the upper Y441 packer under water injection only in the lower layer
m
状态 顶/底部深度 虎克 屈曲 鼓胀 热效应 整体长度变化
注水 0/4 800 0.056 -0.029 -0.739 -2.173 -2.885**
停注 0/4 800 0.013 0.000 -0.003 -0.874 -0.864**
表 6 单独注、停上层时Y441(上)受力 Table 6 The force on the upper Y441 packer under water injection only in the lower layer
状态 F /kN F /kN p /MPa p /MPa t/℃
注水 -64.263 -60.947 52.984 66.967 84.045
停注 -55.416 -36.329 46.344 46.346 122.208
3.2.2 上Y441至下Y441(上封隔器等价于井口)

边界条件设定井深714.28 m,下层Y441封隔器位于600 m,取2封隔器段井深、井斜、方位角导入Wellcat。由于计算单注上层时下封隔器受力(相当于油管在配水器位置堵住,全井水全部注入上层),即无论上层为注水或停注状态,计算过程中油管压力始终为Y441(上)位置处液柱压力46.966 MPa。当上层注水时,套管压力等于全井水全部注入下层时,上层Y441位置处油管压力66.88 MPa,上层停注时套管压力与油管压力相同,同样为Y441(上)封隔器位置处液柱压力。

单独注上层时,上封隔器至下封隔器段管柱伸长、缩短情况及下封隔器受力情况如表7表8所示。

表 7 上Y441至下Y441段管柱长度变化 Table 7 The length changes of the string between the upper Y441 packer and the lower Y441 packer
状态 顶/底部深度 虎克 屈曲 鼓胀 热效应 管柱整体变化
注水 0/600 -0.250 0.000 0.206 0.000 -0.044**
停注 0/600 -0.129 0.000 0.071 0.000 -0.058**
表 8 下Y441受力情况 Table 8 The force on the lower Y441 packer
状态 F /kN F /kN p /MPa p /MPa t/℃
注水 -105.477 -58.631 69.141 49.228 85.020
停注 -55.718 -60.975 48.919 51.194 149.350

表7表8可知,全井水全部注入上层时,无论上层注水或停注,上、下封隔器间管柱收缩与伸长量仅为0~0.058 m且无论上层何种状态,油管对下封隔器始终产生下压力,即单独停注上层时,下层封隔器都不会受向上拉力而解封,上下封隔器间管柱收缩量可不计。

综上分析可知,该区块分层注水管柱结构及伸缩管长度,只要满足单独注入下层要求,即可满足全井分注要求,即上伸缩管控制伸缩距3 m,下伸缩管控制伸缩距1 m,上封隔器解封力108 kN,下封隔器解封力81 kN,就可以满足该区块该种类型井分层注水要求。

4 现场应用 4.1 管柱入井及封隔器坐封

××1井管柱入井后,替环空保护液、投直径29 mm低密度球后小排量送球至水平段,投坐封芯子,待芯子到位后地面小排量泵送球至球座,地面泵车采用5 MPa→10 MPa→15 MPa→20 MPa→25 MPa→30 MPa→35 MPa压力台阶稳压方式加压,32 MPa时管柱底部球座打掉,下层注水通道畅通,封隔器坐封结束。

4.2 下封隔器验封

地面钢丝车带打捞器将坐封芯子捞出,将双探头压力计与注水芯子相连,按图2方式坐入工作筒,地面泵车采用“启泵→停泵→启泵→停泵”方式完成下封隔器验封,验封结果如图4所示。图中蓝色线为油管压力(注入水全部注入下层),绿色线为2封隔器之间压力,红色线为温度线。

图 4 下封隔器验封结果 Fig.4 Seal test results of the lower packer

明显看出2封隔器之间(上层)压力基本保持不变,第1次地面泵车加压时,下封隔器压差为16.75 MPa,第2次泵车加压时,下封隔器压差为11.63 MPa,由此分析下封隔器严密,上封隔器采用套管反加压方式完成验封。

4.3 水量调配及季度验封

下封隔器验封结束后,进行各层吸水指示曲线测量,依据嘴损图版曲线及经验公式,确定各层所需水嘴直径并完成流量验证,完井。

50 m3/d稳定注水3个月后,按要求进行上下层水量调整,要求上层50 m3/d,下层30 m3/d。首先应用地面注水管线进行下封隔器验封,地面采用“开→关→开→关”方式完成验封,验封结果如图5所示,图中蓝色线为油管压力(注入水全部注入下层),绿色线为2封隔器之间压力,红色线为温度线。2轮地面注水阀开关,下封隔器胶筒两端压差分别为5.19和5.90 MPa,由此分析下封隔器密封严密。

图 5 注水3个月后验封结果 Fig.5 Seal test results after three months’ water injection

验封结束后应用钢丝车将注水芯子及压力计捞出,注水芯子连接上、下流量计重新坐入工作筒进行吸水指示曲线测试。依据各层吸水指示曲线及嘴损图版,注水芯子下层加装2.3 mm水嘴限流,全井80 m3/d条件下,测得上层实际注水量为47.6 m3/d,下层实际注水量为32.0 m3/d,满足配注要求,完井。

5 结论

(1)由Wellcat模拟结果可知,该类管柱结构及工具只要满足单独注入下层要求,即可满足全井分注要求,即上伸缩管控制伸缩距3 m,下伸缩管控制伸缩距1 m,上封隔器解封力108 kN,下封隔器解封力81 kN,满足该区块双台阶水平井200 m3/d、25 MPa条件下的分层注水。

(2)该管柱结构共计实施试验井2口,其中××1井分别经历了2次验封、多次停注、启动注水及全井水量逐级降低式分层压力测试,上层实际配注量47.6 m3/d,下层实际配注量32 m3/d,满足地质要求,已稳定注水8个月,管柱工作状态良好。

(3)××2井原井采用笼统注水,下层倒吸,注入水全部注入下层。2015年1月改为分注,地质配注要求上层20 m3/d,下层30 m3/d。该井分注管柱完井后,大排量平衡注水2 d(流量200 m3/d,地面注入压力25 MPa),后经历降压式吸水指示曲线测试等多次变流量、开关井操作。依据各层吸水指示曲线及嘴损图版,下层选择2.6 mm水嘴,经流量验证,上层实际配注量23.7 m3/d,下层实际配注量26.8 m3/d,满足地质要求。

(4)2口井的现场应用结果表明,双台阶水平井分层注水管柱及工具设计合理,可满足双台阶水平井分层注水要求。

参考文献
